Pool Construction Timeline in Florida: What to Expect From Start to Finish

A Florida pool is built in a fixed order of phases, and the calendar is set by what each phase waits on: the permit, the weather, an inspection, or a cure time. Here is every phase in sequence, what gates it, and where the time actually goes.

A pool in Florida is built in a fixed order, and the calendar is set by what each phase waits on: the permit review, the weather, an inspection, or the cure time of concrete and plaster. Crews can be fast; they cannot shorten a cure or skip an inspection. So instead of a week-by-week schedule that would be wrong for your lot, this guide gives you the sequence, what gates each phase, and where projects really gain or lose time.

Before anything is dug

Two phases happen before the yard changes, and they decide most of the schedule.

Design and engineering. Site evaluation, the 3D design you approve, selections, and the sealed structural plans. The time here is mostly decision time on your side: every selection locked before engineering is a change order avoided later. Our guide to the twelve decisions to make before excavation is the checklist we use.

Permitting. The building department reviews the plans; zoning, the HOA, and where they apply the septic and flood-zone reviews run alongside. We cover what each permit is and who issues it. The length of this phase depends on the office and the season, and the fastest way through it is a complete submission the first time.

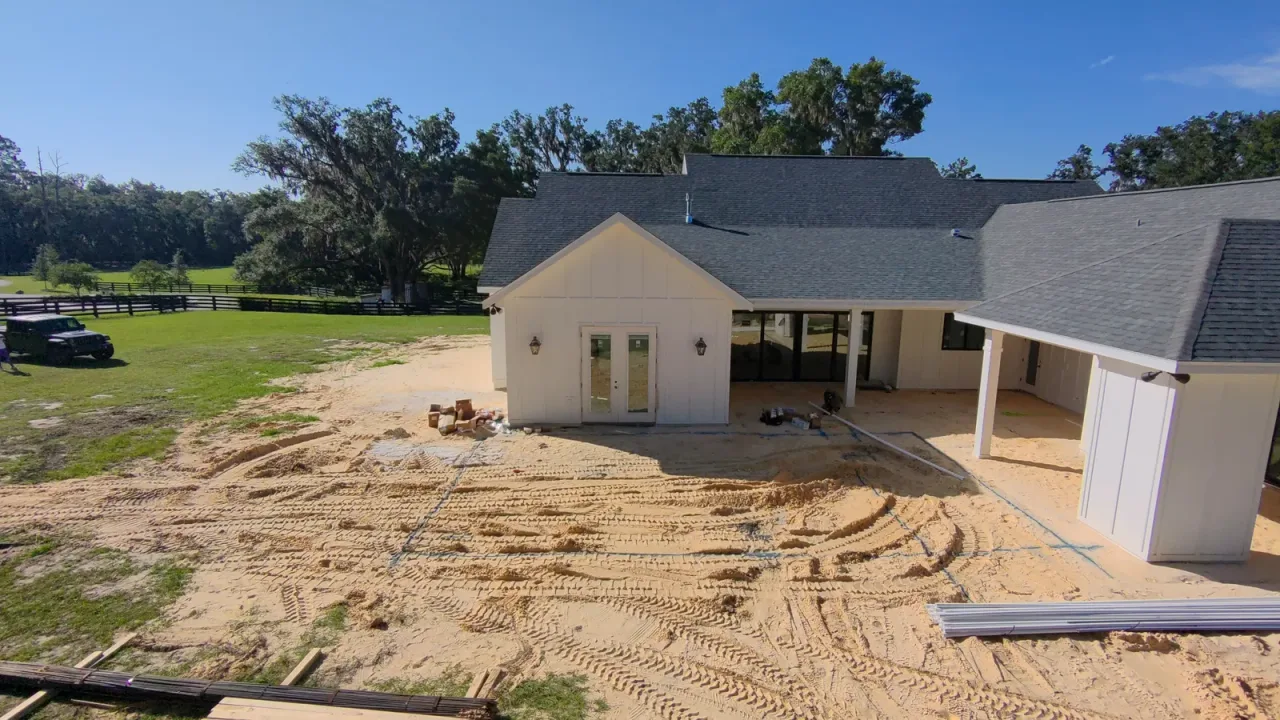

Rear of a white house with blue pool layout lines painted on a sandy, tire-tracked yard, and large trees and pasture behind.

The construction phases, in order

PhaseWhat happensWhat it waits onWhat gates the next phase
1. Layout and excavationShape marked, hole dug to the engineered profile, spoil hauledPermit issued, dry ground, access path openCorrect depth and profile; rock or water table handled
2. Plumbing and steelLines run and pressure-tested, rebar grid tied, bonding grid tied inExcavation completeInspection passes
3. ShellGunite or shotcrete applied over the steel, then curedSteel and plumbing inspectionCure time (not adjustable)
4. Tile and copingWaterline tile and coping set on the cured shellShell curedMortar cure before deck work on the edge
5. Electrical rough-in and deckConduit, lighting, equipment circuits; deck formed and poured or pavers setTile and coping doneElectrical and deck inspections
6. EquipmentPump, filter, heater, chlorination, automation, lighting installed and wiredDeck and electrical inspectionsPower to the pad
7. Interior finish and fillPlaster, quartz or pebble applied; pool filled immediatelyAll dusty work finished, inspections closedStartup chemistry over the first days
8. Startup, barrier, finalSystems run and tested, chemistry balanced, barrier complete, final inspectionsEverything abovePermit closed; pool in use

Phases 5 and 6 can overlap, and the barrier can be built while the finish cures. The three things that cannot move are the inspections (steel before shell, rough-in before the deck, barrier before the final), the shell cure, and the plaster cure.

Where the time really goes

From our projects, the calendar is lost or won in a short list of places.

  • The permit package. A missing HOA approval, an easement left off the site plan, or a septic question discovered late costs more days than any construction phase.
  • Rain. Excavation, gunite and deck pours stop for wet ground. A summer week can lose several working days to afternoon storms; a tropical system can pause a site entirely.
  • The water table and rock. On a high water table, the excavation needs dewatering before steel and shell; on North Florida lots, limestone can slow the dig and change the method. Both are predictable from the site evaluation, which is why we do it first.
  • Selections. A tile or finish that has not been chosen when the shell is cured is the most common self-inflicted delay.
  • Inspection scheduling. Each stage is inspected when the inspector is available. A failed item, often a bonding connection or a gate latch, means a re-inspection.

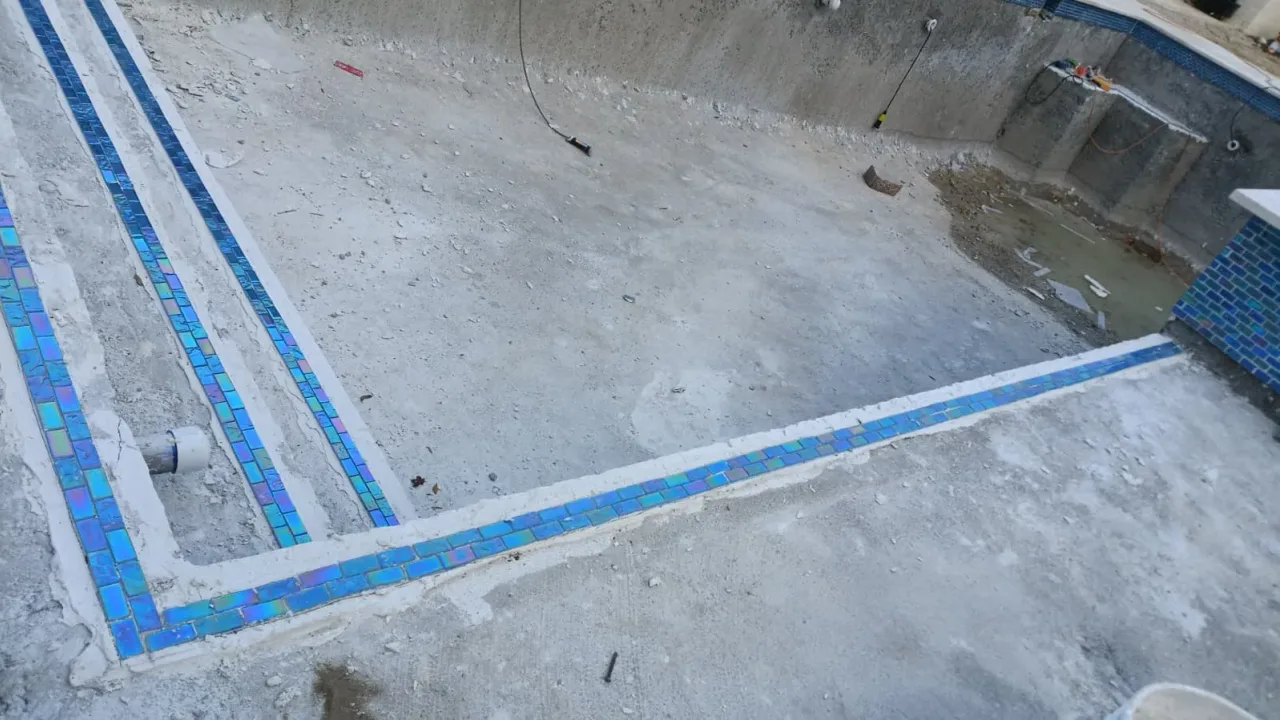

Iridescent blue glass tile outlining the steps and sun shelf of a pool shell before plaster.

Seasons

Florida builds pools year-round, but not evenly. The dry season, late fall through spring, is the predictable window for excavation and concrete, and it is the busy one: design and permitting for a dry-season build should start well ahead of it. Summer builds are possible and sometimes faster to permit; they carry more weather days and the hurricane-season risk of a pause.

Startup is not the finish line

A plastered pool is filled immediately and then balanced over the first days while the finish cures underwater. During that window the equipment runs on a startup schedule and the water chemistry is adjusted daily. We walk you through the equipment and the automation at startup, hand over the closed permit, and the pool is yours. The barrier, the one thing the final inspection will not pass without, is built in parallel, not after.

Rectangular pool behind a two-story house, enclosed by a black mesh safety fence, with a dark-framed patio cover alongside.

What we give you instead of a generic number

After the design is approved and the permit is submitted, you get a schedule for your own project, with the phases above, the inspections marked and the weather risk stated. We update it at every inspection, because a schedule that is not updated is a guess. If you want to see how the phases connect to price and design, start with the complete guide to pool construction in Florida, and when you are ready, request a project evaluation on our custom pool construction page.

Common questions

How long does it take to build a pool in Florida?

It depends on the permit office, the season and the scope, so any single number is a guess. What is fixed is the order of phases and the fact that concrete and plaster need cure time no crew can shorten. We give each client a schedule for their own project after the design is approved and the permit is submitted, and we update it at every inspection.

What is the best time of year to build a pool in Florida?

The dry season, roughly late fall through spring, runs more predictably because rain stops excavation and concrete work. It is also the busy season, so design and permitting should start earlier. A summer build is possible; it just carries more weather days.

Why does a finished-looking pool sit empty for days?

Usually one of three reasons: the interior finish has not been applied yet because tile, deck or equipment inspections were still open; the pool has been plastered and is being filled and balanced; or the final inspection is waiting on the barrier. None of them is idle time, even when nothing visible is happening.

Can the phases overlap to save time?

Some can. Deck work and equipment installation can run alongside each other, and the barrier can be built while the interior finish cures. What cannot overlap is anything an inspection has to see first: steel before shell, electrical rough-in before the deck covers it, and the barrier before the final.
