Pool Automation for New Construction: What to Decide Before the Equipment Pad Is Set

Automation is the part of a new pool that costs almost nothing to prepare for and a great deal to retrofit. The controller can wait; the conduit, the valve actuators and automation-ready equipment cannot. Here is what we decide with clients before the equipment pad is set.

Automation is the part of a new pool that costs almost nothing to prepare for and a great deal to retrofit. The controller itself, the panel at the pad and the app on your phone, can be bought and installed at any point. What cannot be added without opening the deck is the conduit from the pad to the house, the actuators on the valves, the conductors for lights and features, and equipment chosen to be controlled rather than switched. This guide covers what automation does, what it needs buried, and how to decide what to install now and what to leave for later.

What automation controls

A modern pool controller is a panel at the equipment pad with relays, valve actuator outputs and communication to the equipment, plus an app. On a residential pool it runs:

  • The pump: speeds and schedules, slow for filtration most of the day, fast when a feature or the spa calls for it.
  • The heater and its set points, including switching between pool and spa temperatures.
  • The valves that send water to the pool, the spa, the sheer descents, the bubblers and the deck jets, with actuators doing what a person would otherwise do by hand at the pad.
  • The lights: on, off, color and scenes for the pool, the spa and, if they are wired to it, the deck and the landscape.
  • Sanitation: the output of a salt chlorine generator, and with sensors, pH and sanitizer monitoring and dosing.
  • Spa mode: one button that closes the valves, raises the pump speed, starts the heater and turns on the jets.

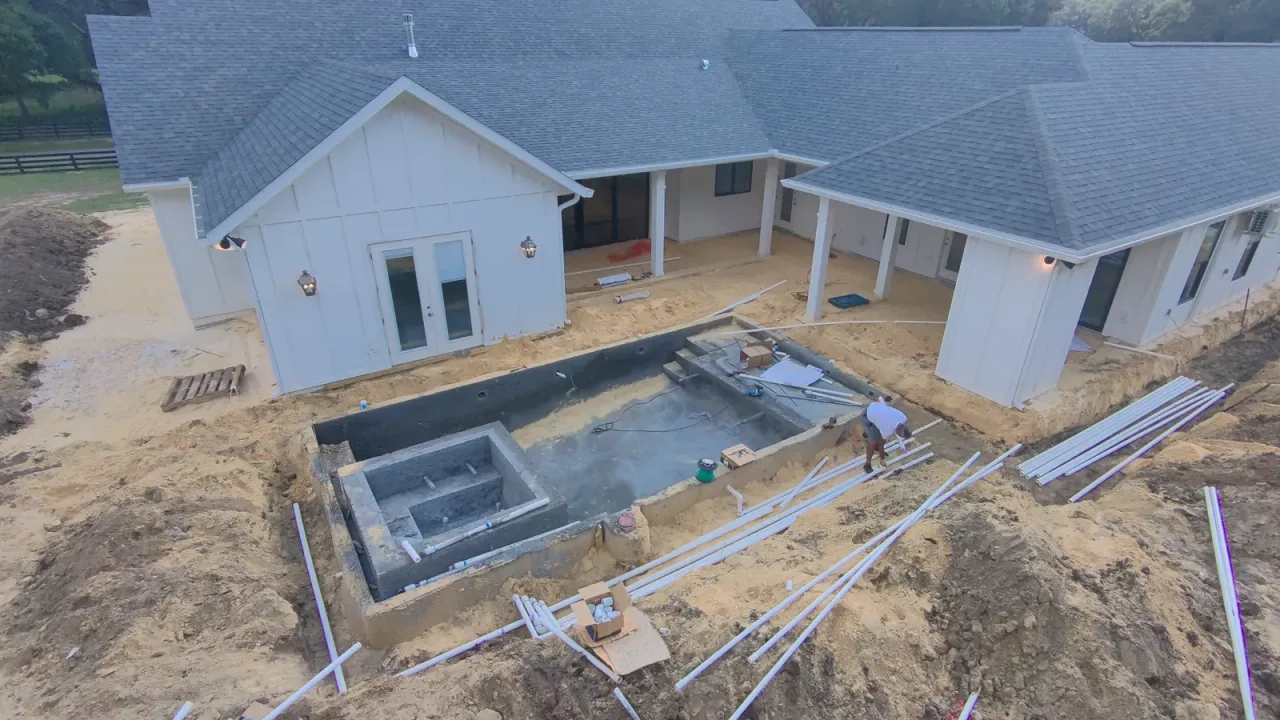

Aerial view of a gunite pool shell with its spa, and lengths of PVC pipe laid out on the sand behind a white house.

What has to be buried during construction

This is the whole reason to decide automation before the pad is set.

ItemWhen it goes inWhat it costs to add later
Conduit from the pad to the house or panel locationRough plumbing and electricalTrenching under the finished deck
Valve actuators on every pool/spa/feature valveEquipment setRe-plumbing the pad
Conductors for pool, spa and feature lights on separate circuitsRough electricalPulling new wire through full conduit, or new conduit
Conduit for deck and landscape lightingBefore the deck is pouredTrenching
Automation-ready pump, heater and chlorinatorEquipment selectionReplacing equipment that works
Sensor ports for chemistry monitoringPad plumbingCutting into the plumbing

Our guide to upgrades worth planning before construction sorts every upgrade on a proposal by the same rule: what closes at the shell, what needs something buried, and what can wait. Automation is the clearest example of the second category.

Equipment that works with automation

The controller is only as useful as the equipment it can talk to.

  • Variable-speed pump. Federal efficiency rules for dedicated-purpose pool pumps have meant that most new filter pumps are variable-speed since 2021, and that is what makes scheduling worthwhile: filtration at low speed for most of the day, full speed only when the spa or a feature needs it. The pump and the controller should speak the same protocol.
  • Heater or heat pump with a control interface, so the set points live in the app. A heat pump that also cools matters on dark-finish pools and in the South Florida summer.
  • Salt chlorine generator whose output the controller can set, so sanitation follows the pump schedule.
  • Lights that accept color and scene commands from the controller rather than from a switch sequence.
  • Features on their own valves with actuators, so each can be called separately.

We specify all of it as one system from one manufacturer family where that is possible, because mixed equipment is where automation becomes a service call. Which family depends on the project, and we go through the options in design.

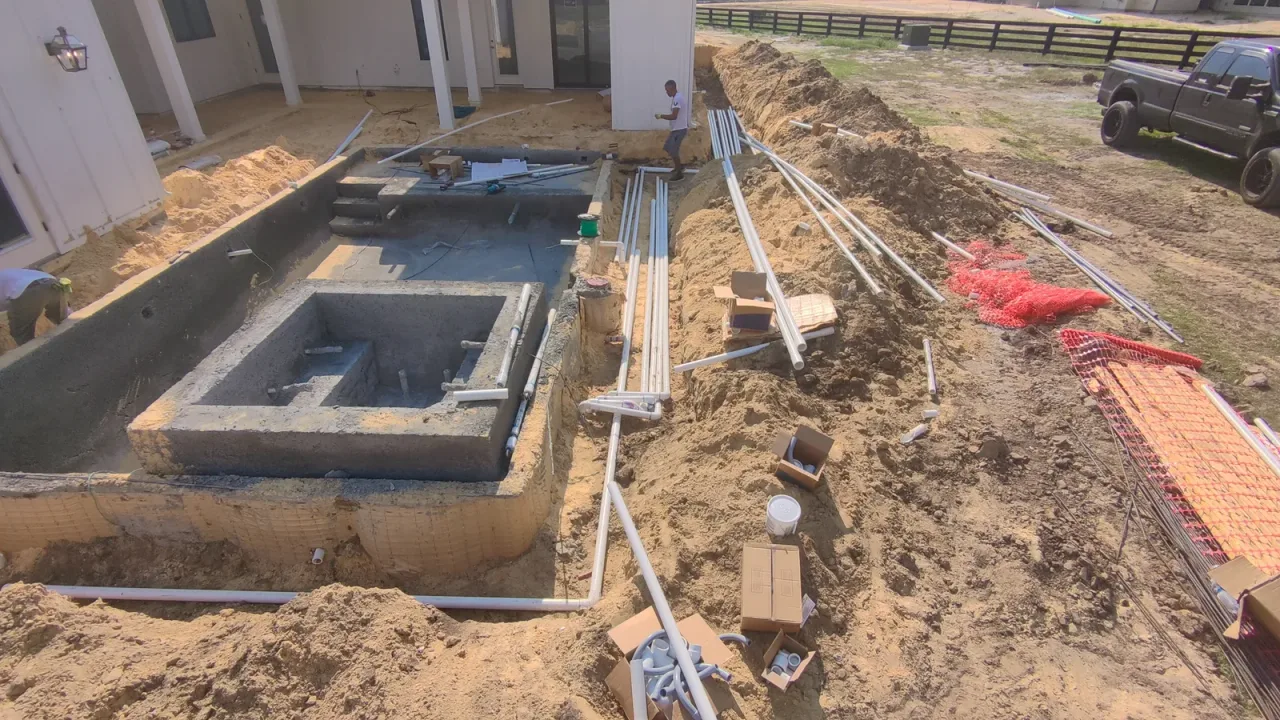

PVC plumbing lines running in a trench from a gunite spa toward the far end of the site, with fittings boxed on the sand.

Deciding what to install now

The decision is three separate lists:

  1. Install during construction, no exceptions: conduit, actuators, conductors, automation-ready equipment, sensor ports. This is the cheap part and it is the part that cannot wait.
  2. Install now if the budget allows: the controller itself and the app. On most of our new pools it goes in with the equipment, because the spa, the heater and the features are easier to run from the first day.
  3. Add later without regret: chemistry sensors and dosing, landscape lighting scenes, integration with a home system. All of it plugs into the prepared infrastructure.

If the controller is deferred, the pool is still fully usable; the owner runs the pad by hand and the pump on its own built-in schedule until the controller is added.

Florida specifics

Three things change how we design automation here:

  • Lightning and power. Surge protection at the pad and the panel is not optional in Florida, and the controller should recover its schedule after an outage without being reprogrammed.
  • Heat. Scheduling the pump and the features at night moves water and sheds heat; a heat pump that cools becomes an automation set point rather than a manual job.
  • Weather and absence. Many Florida owners are away for part of the year. Remote monitoring of pump status, water level, heater faults and chemistry is what keeps a pool from being a problem when nobody is home.

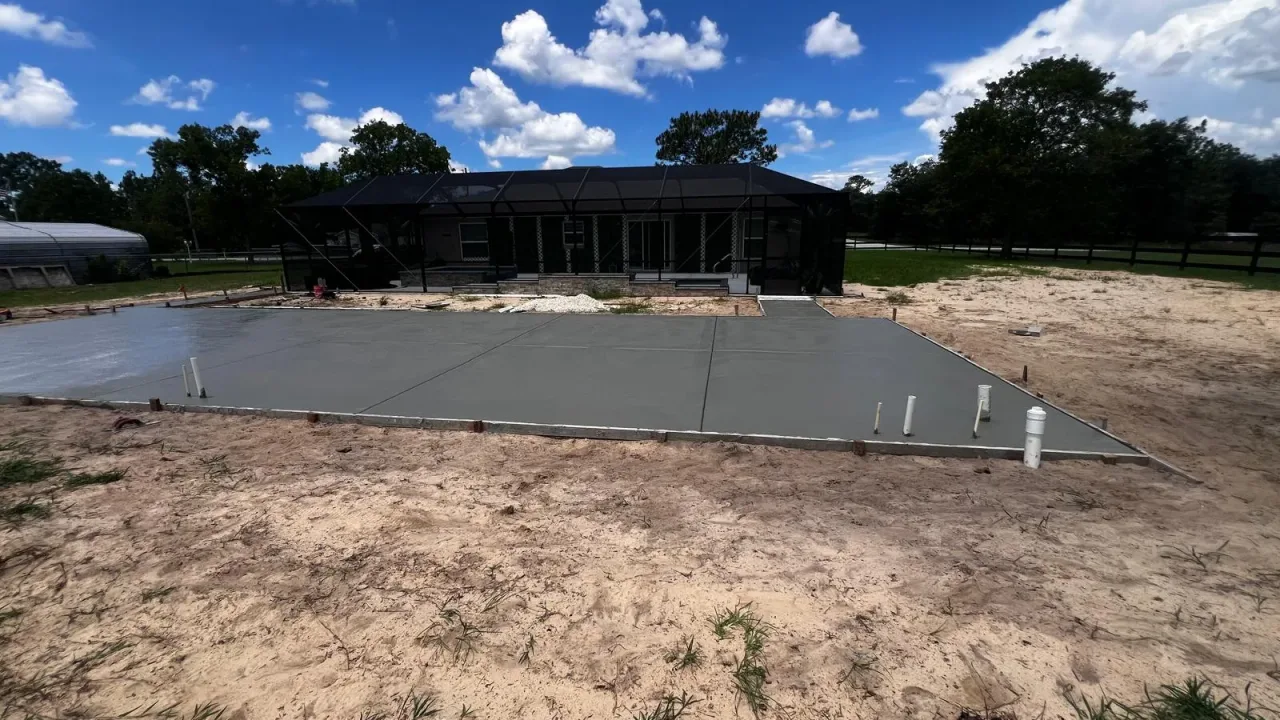

Freshly poured concrete slab with edge forms and plumbing stubs, in front of a black screen enclosure on a sandy lot.

How it fits in the build

Automation is decided with the equipment list in design, and its infrastructure is installed at the rough plumbing and electrical stages that the pool construction timeline in Florida describes. By the time the deck is poured, every conduit and conductor the system will ever need is in the ground. It is a small line in the plan and a large one in what the pool is like to own; several of the designs in our ten luxury pool designs for Florida homes depend on it.

When you are planning a pool, bring the question up early and ask for the two lists: what is buried, and what is bought. Request a project evaluation on our custom pool construction page and we will prepare both for your lot.

Common questions

What does pool automation actually control?

The pump speeds and schedules, the heater and its set points, the valves that switch water between the pool, the spa and the water features, the lights and their colors, the salt chlorine generator, and, with the right sensors, chemistry monitoring. All of it from a panel at the pad and an app on your phone.

Can I add automation to a new pool later?

The controller, yes. What is hard to add later is the conduit from the equipment pad to the house, the valve actuators on the plumbing, the extra conductors for lights and features, and equipment that was not chosen to be controlled. If those go in during construction, the controller can be added any time. If they do not, adding it means trenching and replacing equipment.

Do I need a variable-speed pump?

On a new pool, almost certainly. Federal efficiency rules for dedicated-purpose pool pumps have meant that most new filter pumps are variable-speed since 2021, and they are what makes schedules and feature control worthwhile: the pump runs slowly most of the day for filtration and ramps up when the spa or the waterfalls call for flow.

Does automation replace pool service?

No. It runs the equipment on schedule, keeps the spa at temperature, reports faults and, with chemistry sensors, tells you when the water drifts. Someone still brushes, cleans the filter, adds chemicals and inspects the equipment. What automation does is make that work predictable and catch problems between visits.
