Do You Need a Permit for a Pergola in Florida? What Homeowners Should Know

The answer is almost always yes. The part worth your time is which reviews a pergola triggers, because that is what decides the drawings you need and the two inspections that can stop the job.

Yes. In practice a pergola in Florida is permitted work, attached or freestanding, aluminum or timber, on a new slab or an existing patio. The more useful question is not whether but which: a pergola does not get one review, it gets a set of them, and which ones apply is decided by where it sits, what it touches, and whether anything electrical goes into it. That is what sets the drawings you have to produce and whether the file clears in one comment cycle or three.

This covers what gets reviewed, the order things happen in, and the two inspections that stop a job if you miss them. Permits for the pool itself are a different set, covered in what permits are required for pool construction.

Two things that are true everywhere, before the local part

The building department decides, not the vendor. A salesperson who tells you a pergola is "just a shade structure, no permit needed" is describing a category, not making a determination. The jurisdiction that covers your address is the only one that can say what its threshold is.

Being exempt from a permit is not being exempt from code. In the narrow cases where a small open structure falls under a permitting threshold, it still has to meet wind, setback and barrier requirements. The exemption removes the paperwork, not the standard. That matters later, because an insurance adjuster and a buyer's inspector both look at the structure, not at the file.

Beyond those two, this is a county-and-city question rather than a Florida question. What Alachua County asks for is not what Broward asks for, and the City of Gainesville is a separate authority from the county that surrounds it. Ask which one reviews your address before you assume.

What actually gets reviewed

A permit application for a pergola is not one review. It is a set, and each one is triggered by something physical:

What the pergola touchesWhat that triggers
The groundStructural review of footing size, depth and anchorage, plus a footing inspection before any concrete is placed
WindStructural review showing the system resists the design wind speed at your address, either through sealed drawings or a product approval used inside its limits
Your house wall or roofReview of the *existing* structure as well as the new one, because attaching changes where load goes
Property lines, easements, drainageZoning review of setbacks, lot coverage and how much of the lot is now impervious
Lights, fans, outlets, heatersElectrical review, with its own rough inspection before anything is closed up
A pool barrierBarrier review, because a post, a counter or built-in seating can change whether the barrier still works
An existing screen enclosureThe enclosure was engineered and approved as a unit, so tying into it reopens that approval

Read that list as a checklist of your own yard. Most delays come from a review nobody realized had been triggered.

Attached or freestanding changes who looks at it

Attaching a pergola to the house is the single decision that most changes the review. It puts the new structure's load into your existing wall or roof, so the reviewer has to be satisfied about the condition and capacity of what is already there, the attachment detail, and sometimes the roof's own approval where the cover ties into it.

Standing free of the house avoids that entirely and replaces it with zoning. Setbacks from property lines, distance from the septic field or easements, and the rules for where an accessory structure may sit are the questions that decide a freestanding footprint. The trade-off between the two is the subject of attached versus freestanding pergolas; here, treat it as the fork that sets your review path.

Gable patio cover on dark metal posts attached to a cream stucco house wall, over a travertine paver patio, with white French doors and a white vinyl fence alongside.

Wind is the review that sets your timeline

Florida structures are designed to a wind speed specific to the address, so an open roof cannot be permitted generically. There are two ways to satisfy that, and the one you use is worth knowing before you sign anything:

  1. Sealed drawings. A Florida-licensed engineer designs or evaluates the structure for your site and seals the drawings. This is the route for custom timber work, unusual spans and anything modified from its standard configuration.
  2. A product approval. A manufactured system already carries documentation for the conditions it was tested under, and the submittal shows your installation sits inside those limits. This is faster, and it is a large part of why an aluminum system typically moves through a building department more easily than a one-off timber pavilion.

A contractor who cannot tell you which of the two applies to your project has not priced the engineering, which means the number you were given is not the number. The durability side of the same choice is in aluminum versus wood pergolas.

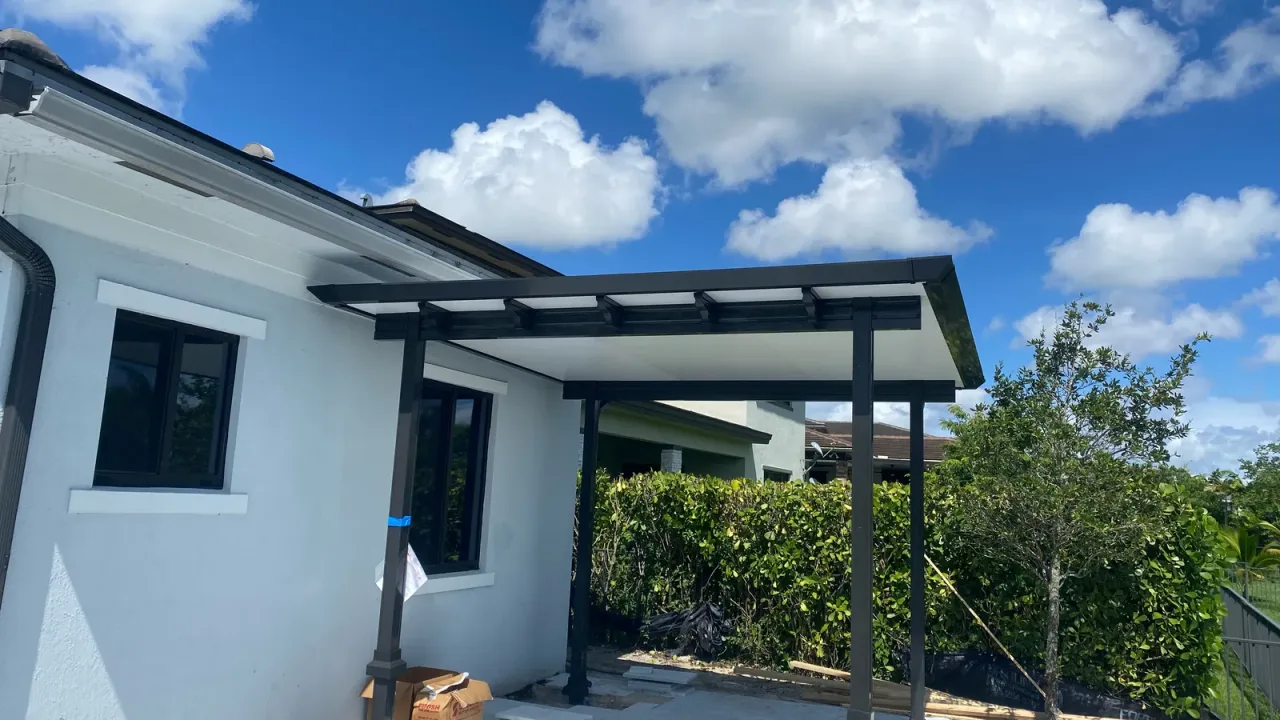

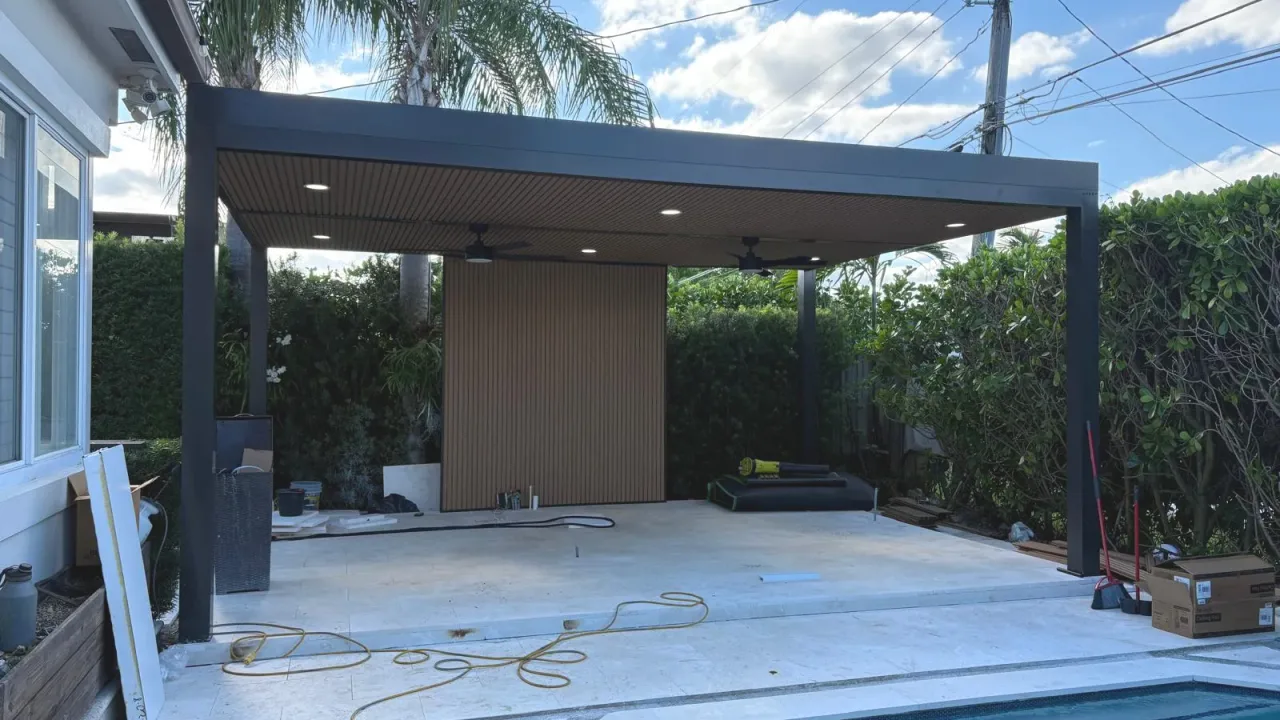

Electrical is where the paperwork doubles

Fans, downlights, an outlet for a television, a heater, speakers: any of them adds an electrical review and an electrical inspection to the job. The inspection is a rough inspection, which means it happens while the conduit and boxes are still visible.

This is the most common expensive mistake on a pergola, and it is not really a permitting mistake. It is a sequencing one. Conduit run inside an aluminum post is invisible the moment the post is closed and capped. Deciding two weeks later that you want a fan means opening the structure back up, and a fan in particular has to be supported by something rated to hold it rather than by a box added afterwards.

Decide the electrical before the footings, not after the frame is up. That decision sits alongside six others in the design decisions to make before construction starts.

Freestanding dark bronze aluminum pergola with a louvered roof beside a pool and spa, one black electrical cable left hanging from a beam where a fixture will go, and a louvered privacy screen underneath.

If it goes near the pool, the barrier is part of the application

A pool barrier is its own permitted, inspected thing, and a pergola built next to it can disturb it in ways that are obvious once you see them and easy to miss on paper. A post set just outside the fence line, a bar counter, a built-in bench or a planter can give a child a foothold, or open a gap where the barrier meets the new structure.

Reviewers look for exactly this, which is the good news: it is caught at plan review rather than at final inspection, as long as the pergola and the barrier are drawn on the same sheet. Drawn separately, it gets caught later and costs more. What else is worth deciding at the same time is in planning a pergola beside a pool.

The same logic applies to anything else added over the same footprint. A raised deck underneath is its own permitted item with its own structural review, and swapping the open roof for a motorized one puts a motor and its wiring into the electrical review as well; that comparison is in pergola versus louvered roof.

Aluminum patio cover next to a pool, with removable mesh safety fencing along the water and construction plastic still lying on the grass.

The HOA is not the county, and it goes first

An HOA has no authority over the building code and cannot issue or withhold a permit. It can still stop your project, and it runs on a meeting calendar rather than a review queue, which means it is the one part of the sequence you cannot speed up.

File it first. A permit issued by the county does not cure an architectural review denial, and rebuilding a submittal to satisfy the HOA after the engineering is already sealed means paying for the drawings twice. Our estimator carries a $1,500 line for HOA submittal work where a community requires it, which is there because the work is real rather than because it is a fee anyone is charging you.

The order it actually happens in

  1. Fix the scope: attached or freestanding, the footprint, and every electrical item.
  2. Submit to the HOA or architectural committee if there is one.
  3. Assemble the structural package, either sealed drawings or the product approval and installation details.
  4. Apply. Zoning, structural and electrical reviews usually run in parallel, each with its own comment cycle.
  5. Permit issued and posted on site.
  6. Footing inspection, before concrete is placed.
  7. Electrical rough inspection, before posts and beams are closed.
  8. Final inspection, and the structure is on the record.

Steps six and seven are the two that stop a job. Everything else on that list can be corrected on paper; those two cannot be caught up afterwards without taking something apart. A contractor who schedules around them is telling you they have done this often enough to have a process.

Who pulls it

The contractor doing the work, under their own license. If you are asked to pull an owner-builder permit for a structure someone else is building, the liability for that construction has moved to you, and it stays with you at resale. The licensing questions worth asking before signing anything are set out in how to choose a builder; they apply to a pergola contract as much as to a pool one.

What it costs, and what we will not pretend to know

Permit fees are set by the jurisdiction, so there is no honest single number for a Florida pergola permit. Our estimator carries a permit line at 9% of the pool and deck total, and that line is for pool work: it does not cover a pergola and you should not apply it to one.

What the estimator does carry for this cluster is $8,500 for a pergola as a starting structure and the $1,500 HOA submittal above, with everything it shows held to a Β±10% range. Those are the figures behind the pool cost estimator, and what moves them for a pergola specifically is broken down in what changes an aluminum pergola's price.

What skipping it costs later

  • At resale. An unpermitted structure surfaces in disclosure and in the appraisal. A buyer's lender can make it a condition of closing, which puts you on somebody else's deadline.
  • After a storm. A claim involving a structure with no permit history is a harder claim, and the questions arrive at the worst possible moment.
  • Through code enforcement. These cases almost always start with a complaint. The remedy is after-the-fact permitting, which means proving what is already buried, sometimes by exposing it.

None of those are likely in the first year. All of them are permanent until resolved.

What to ask before you sign

  • Which authority reviews this address, the county or the city?
  • Sealed engineering or a product approval, and which one are we using?
  • Whose license does the permit go under?
  • Is the electrical on this permit or a separate one?
  • Who pays if the plans come back with comments and need resubmitting?
  • Who calls the inspections, and what happens the day one fails?

A contractor who has answers ready for all six has permitted enough of these to have been caught out once already. That is what you are buying.

How we handle the submittal, the engineering and the inspections is on the custom aluminum pergola page, and finished work across North and South Florida is in the project gallery. A project estimate starts with a site visit, because setbacks, the barrier and where the power comes from are all things that have to be looked at rather than described.

Common questions

Do I need a permit for a freestanding pergola in Florida?

Expect one. Standing free of the house removes the review of how the structure attaches to your home, but it adds zoning questions about setbacks and where an accessory structure may sit. The building department that covers your address decides, and in many towns that is the city rather than the county.

Does a pergola kit bought off the shelf still need a permit?

Where the structure came from does not change what gets reviewed. What it changes is whether there is an approval document you can submit and whether the kit is being installed inside the limits that approval covers. Without one, the structure has to be evaluated for your address before it can be permitted.

Is HOA approval the same as a permit?

No. They are separate systems with separate authority. An HOA approval does not satisfy the building department, and an issued permit does not satisfy the HOA. File the HOA submittal first, because its calendar is the one you cannot influence.

What happens if a pergola was already built without a permit?

The route back is after-the-fact permitting. Because a reviewer cannot see footings or anchorage that are already covered, expect to have to prove them, which sometimes means exposing work that is finished. It costs more than permitting it in the first place, and the alternative on the table is removal.

Who should pull the permit, me or the contractor?

The licensed contractor doing the work, under their own license. An owner-builder permit moves responsibility for the construction onto the homeowner, and most people who sign one do not realize that is what changed.
